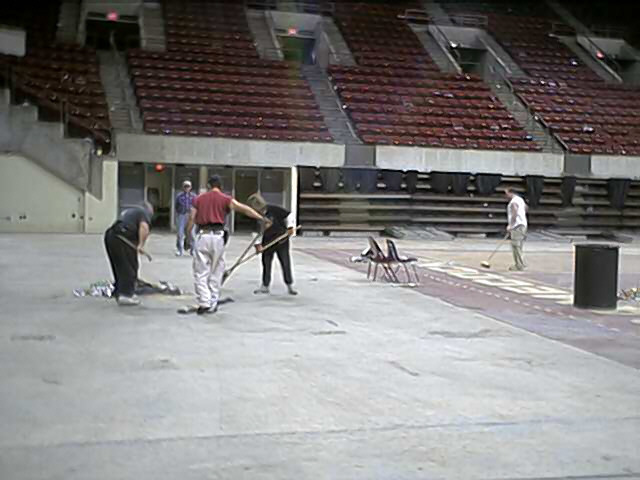

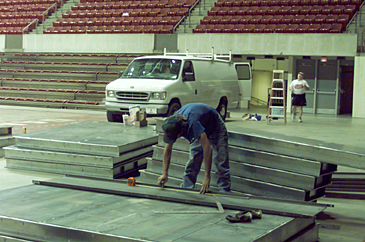

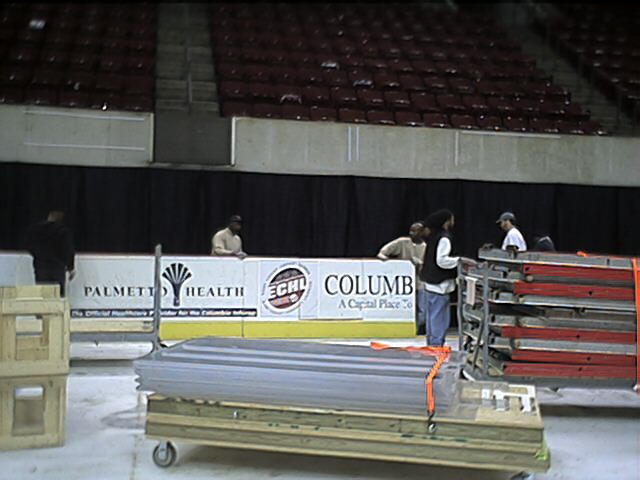

Week 1 work begins on bleachers. Steel plates arriving for Greene St. bleachers. August 7-8-9, 2001. Hockey items start to arrive here at the building for the season - gycol, pumps and tank.

Week 2 August 13-14-16, 2001 Blossom St. bleachers get the retro fit. Homosote shows up- yes it's used if you can't tell from the photos...

Week 3 August 20-21-22-23, 2001 Assembly St. bleachers are started on. Assembly St. bleacher steel still being worked on Aug. 30-31 as well as September 4.

Week 4 Aug.27 Assembly St. gets finished and Park St. is begun (atleast by the bleacher crew).

WEEK 5 SEPTEMBER 4, 2001 Still trying to finish up the steel on Assembly St. bleachers. And still working on Park St. decks. Still drilling holes in the steel plates.

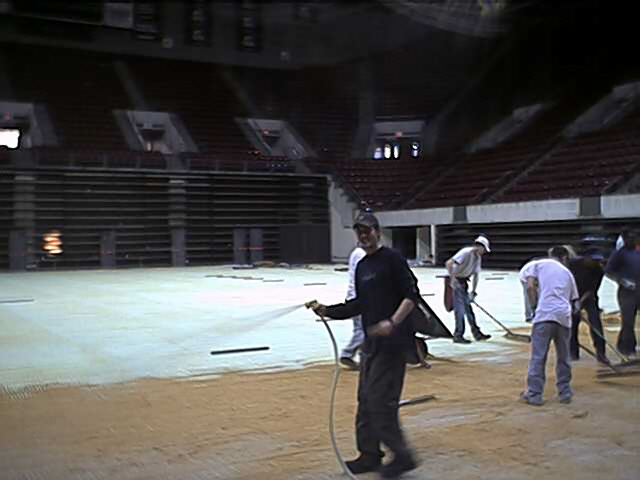

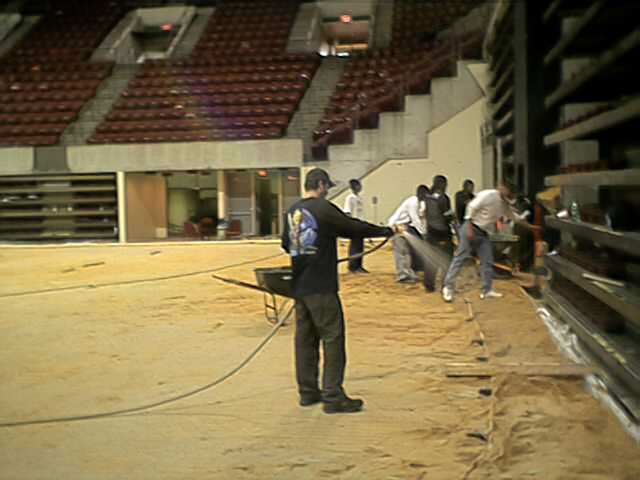

WEEK 5 SEPTEMBER 10-14 FINISHING UP ON PARK ST. REMOVE THE DECKS AND TRACKS FROM ARENA. SEPARATE ALL THE TRACKS FROM STEEL DECKS IN AREAS THAT THE ICE WILL NOT BE INSTALLED. SEPTEMBER 15 - DAY 1 OF ICE IN REMOVE ALL STEEL PLATES FROM TRENCH AND INSTALL 2 HOSES FROM THE OUTSIDE COMPRESSOR TO THE HEADER PIPE IN THE ARENA. WEEK 6 SEPTEMBER 17 - 22 ice dam installed, coils laid, sand spread, insulation laid out, watering, dasher walls up, watering, players boxes, pentality boxes... WEEK 7
SEPTEMBER 23-28
Watering shifts, peel dasher decals, wait for glass- it arrives on the 26th to be installed on the 27th. |  |

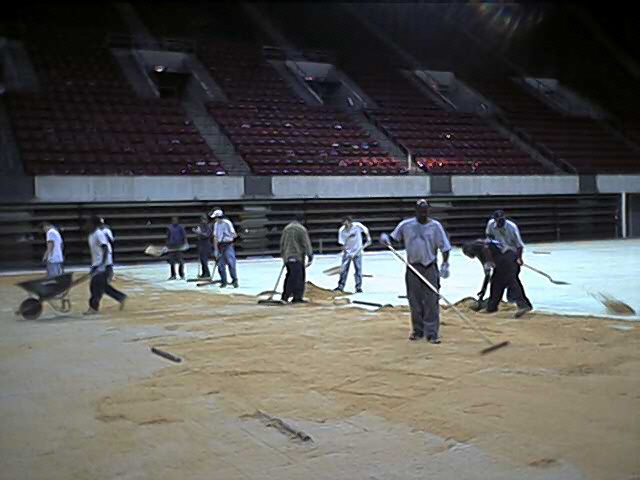

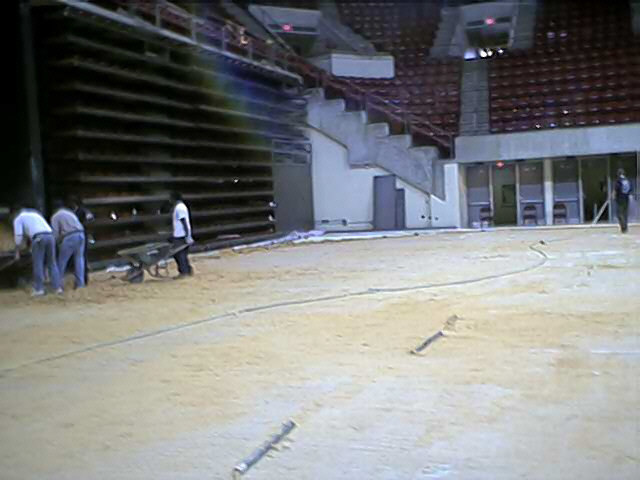

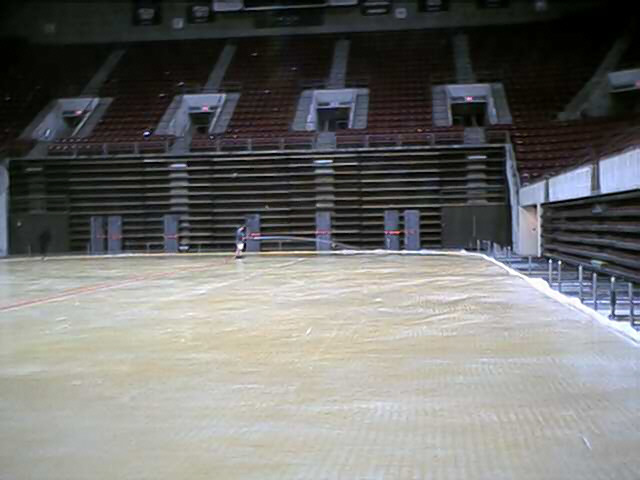

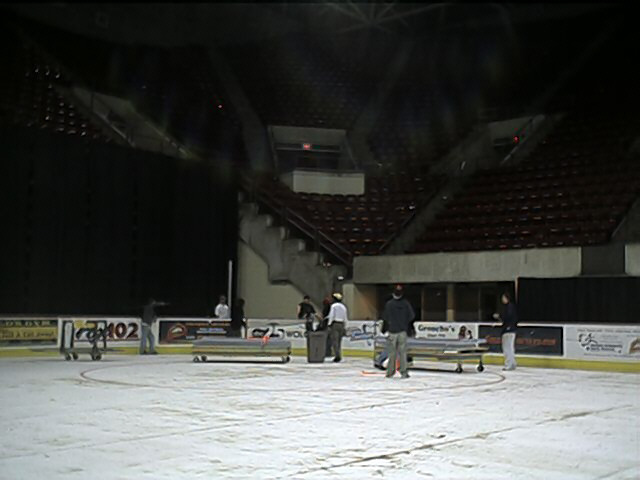

Sometime after 2pm on January 28,2002 the dirt crew arrives from Hartsville and begins shoveling out the dirt.

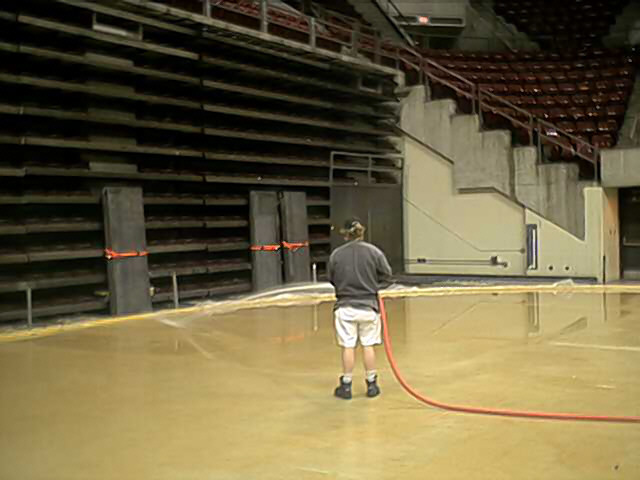

Sometime after 3pm the first scheduled watering shift can actually get some work done.

Regular watering shifts began at 2pm January 28 and went around the clock until January 30 @ 11pm (the last one ended at).

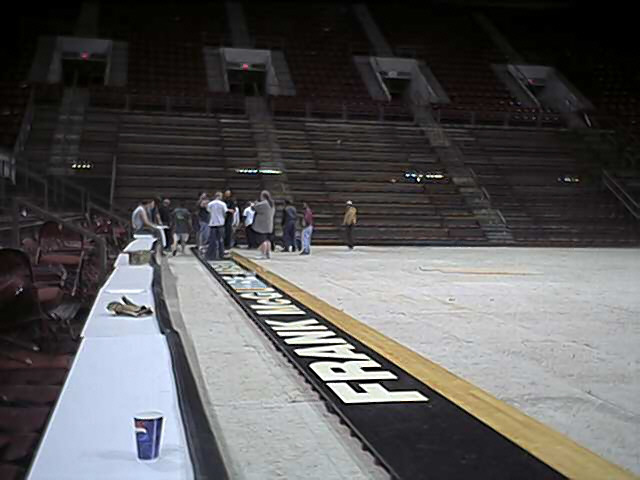

At 12am January 31 the basketball in begins.

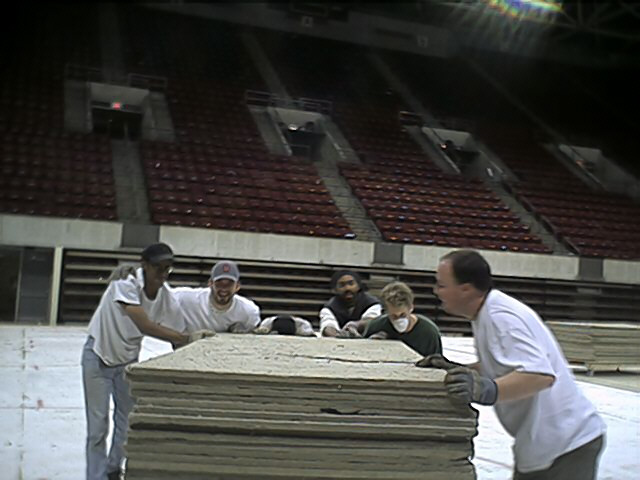

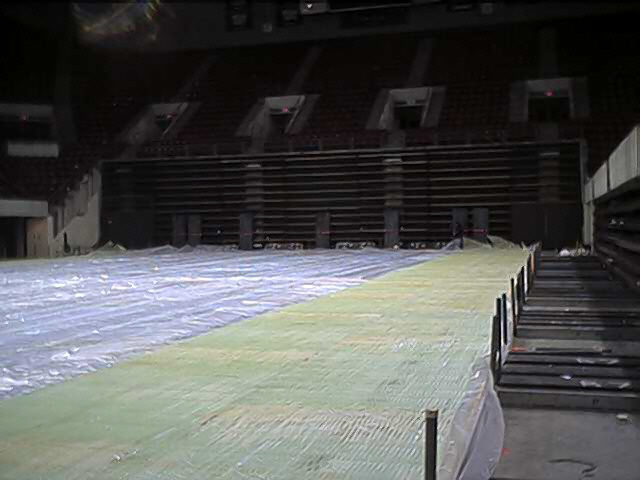

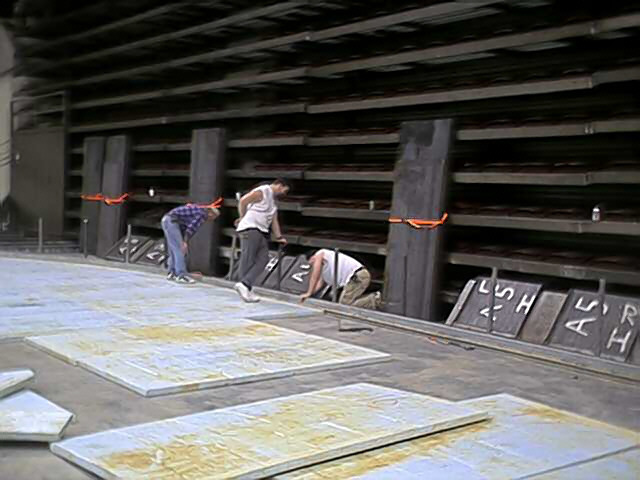

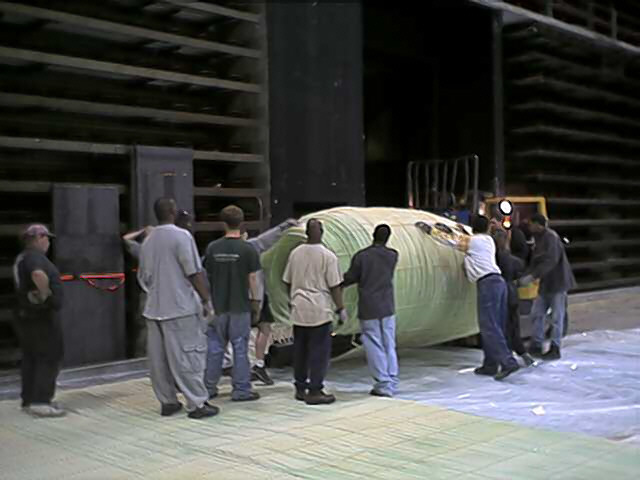

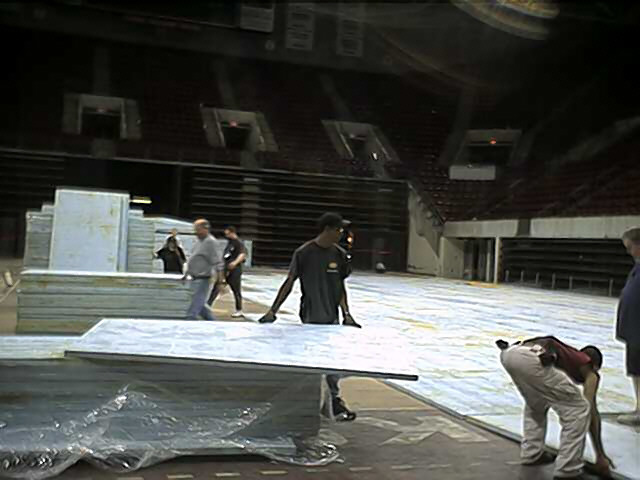

The homosote/prodeck comes into the arena |

|

The riggers put the lights back up |

|

as the floor is covered. |
A completed covered section of floor (ice). |

|

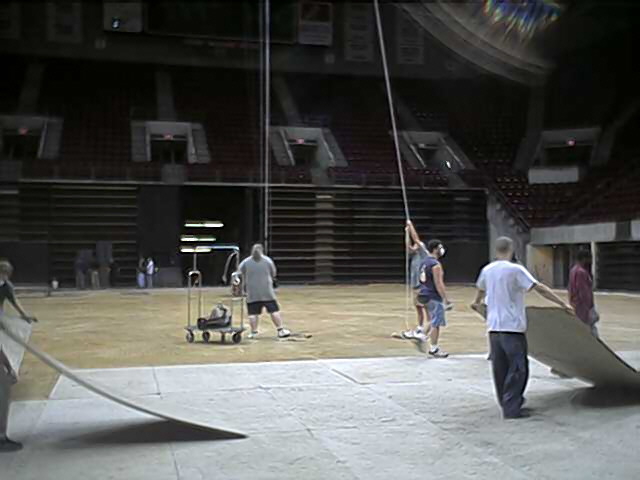

Now the plywood arrives. This will assist in |

|
leveling the floor so the steel with sit properly. |

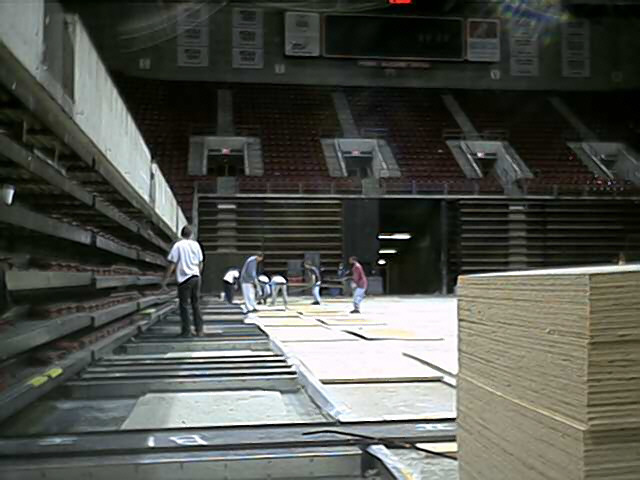

Park St is now covered with plywood so it's time |

|

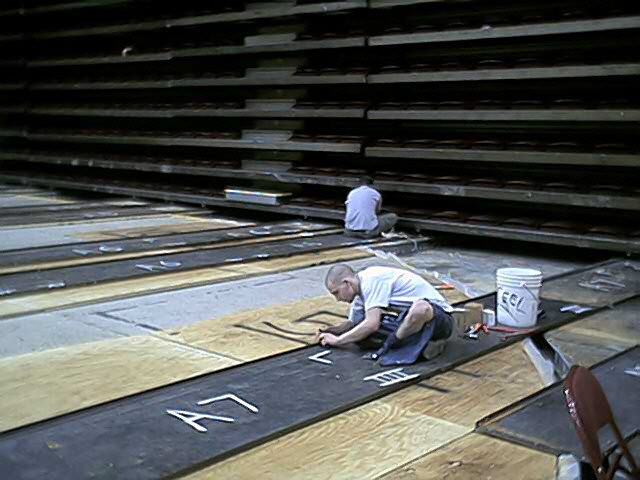

to start laying steel. |
This is Assembly St. steel but you get the idea. |

|
Park St. steel going in (viewed from a distance). |

|

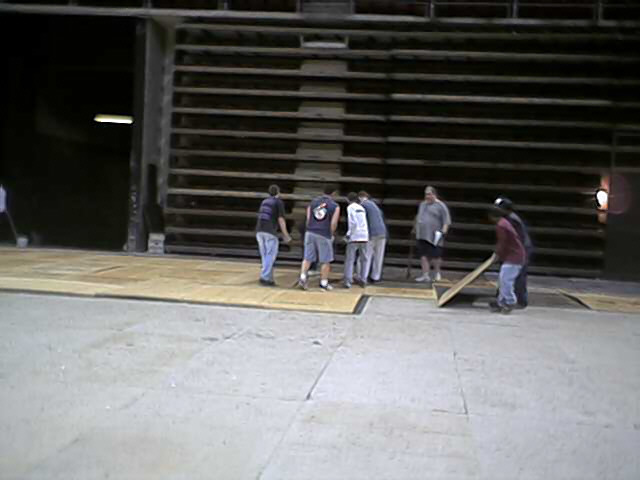

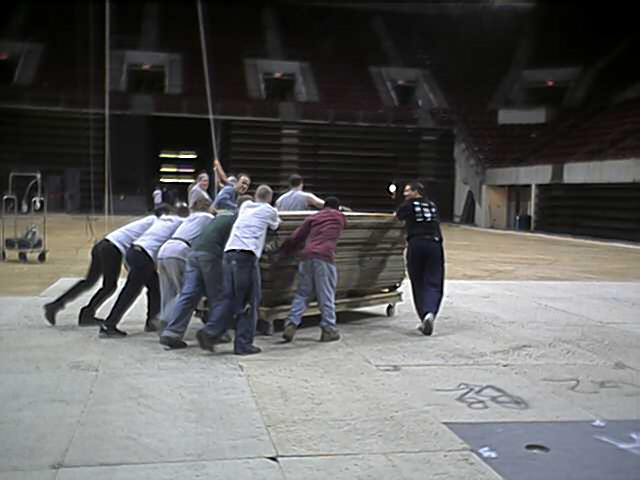

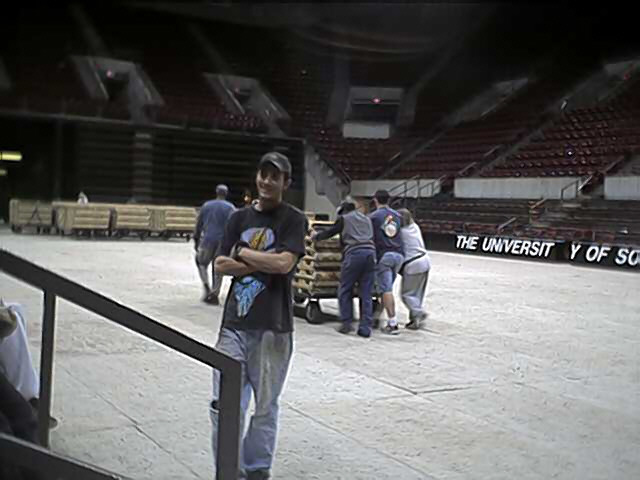

The basketball floor carts arrive. Yes, they are |

|
brought out onto the floor by manual means. |
The first row of floor is laid and the night is |

|
almost over. |
Now the basketball game is done so it's time to return to hockey and finish making the ice.
This series of pictures begins about 2- 3 hours into the call.
With the basketball floor out of the way |

|

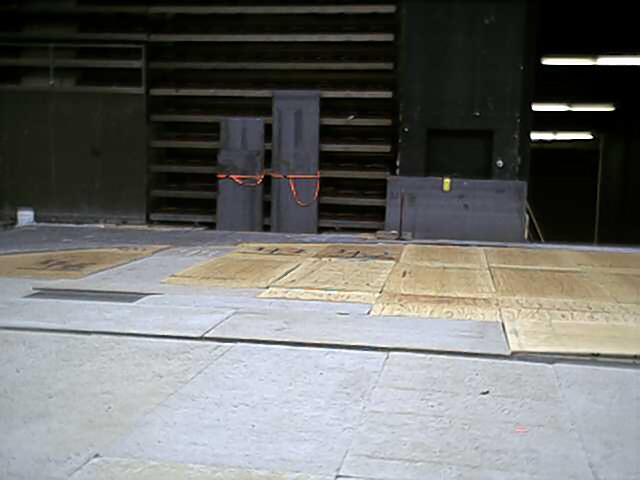

the homosote comes up. |

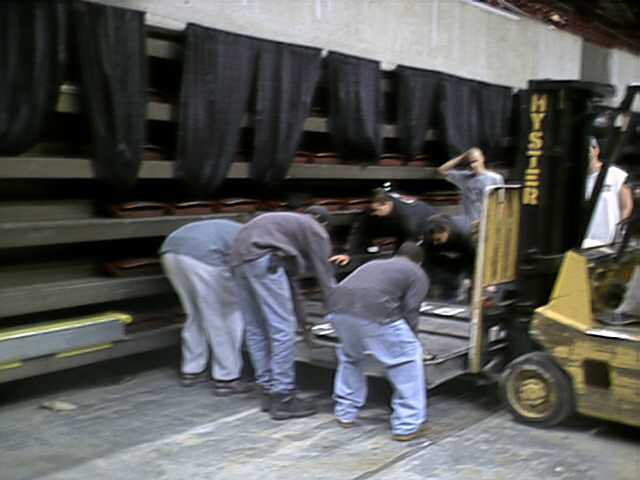

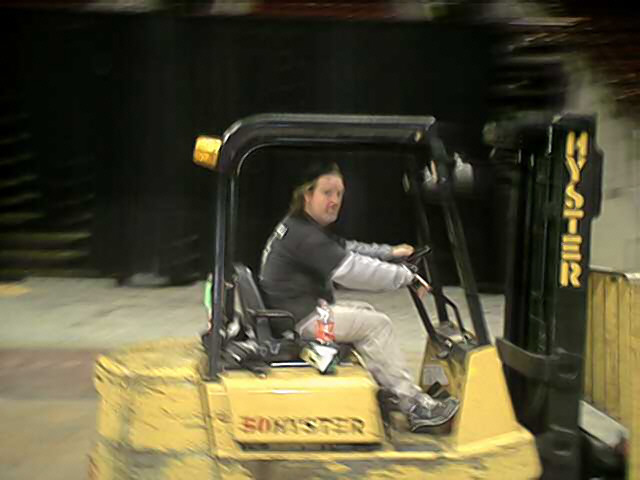

Hockey gear returns to the arena. The uprights |

|
for the glass is one of first carts in. |
Dashers and glass completes the hockey |

|
rink supplies. |
Now that most of the dashers are in, the |

|
glass crew begins. |
After the walls are up but before the glass comes |

|
in it all has to be level and flush. |
With glass going in the suites are set up and |

|
it's almost time to go home. |
|
